Create A Phase Gate Project

Create A Phase Gate Project

A Phase Gate project is always created based on a project template.

Before you can create a project, you must first create a project template, assign a "Phase Gate Review Process" to this template, and then link it to a specific project type. Please note that you can assign only one template to each project type. However, you can define as many project types as needed.

The procedure is the same whether you use the Project Wizard or create a project without the wizard.

Once these prerequisites are completed, you can create a new project.

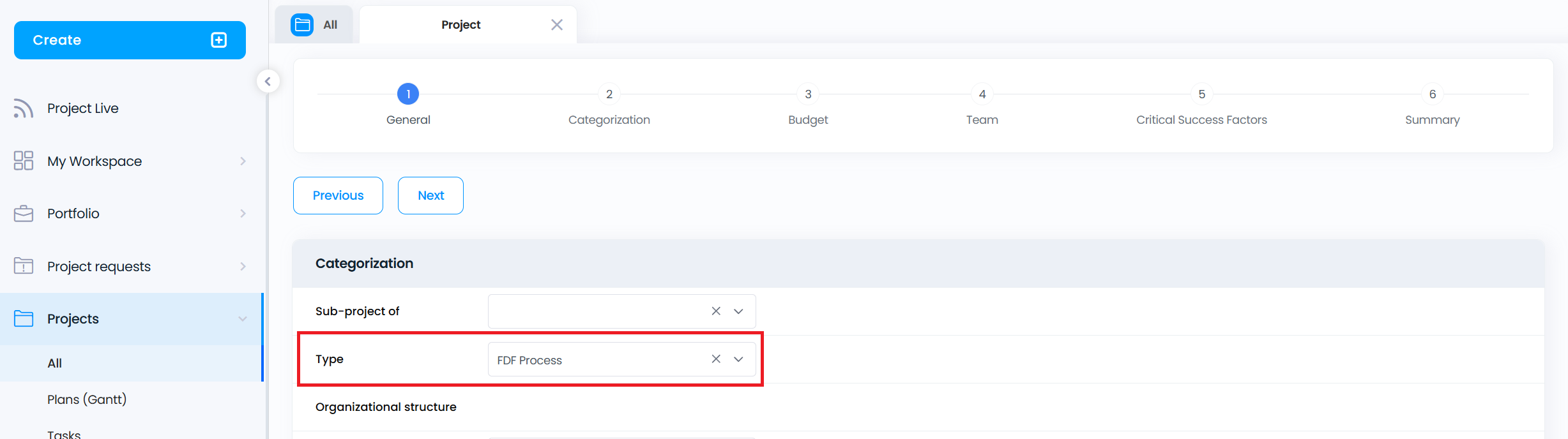

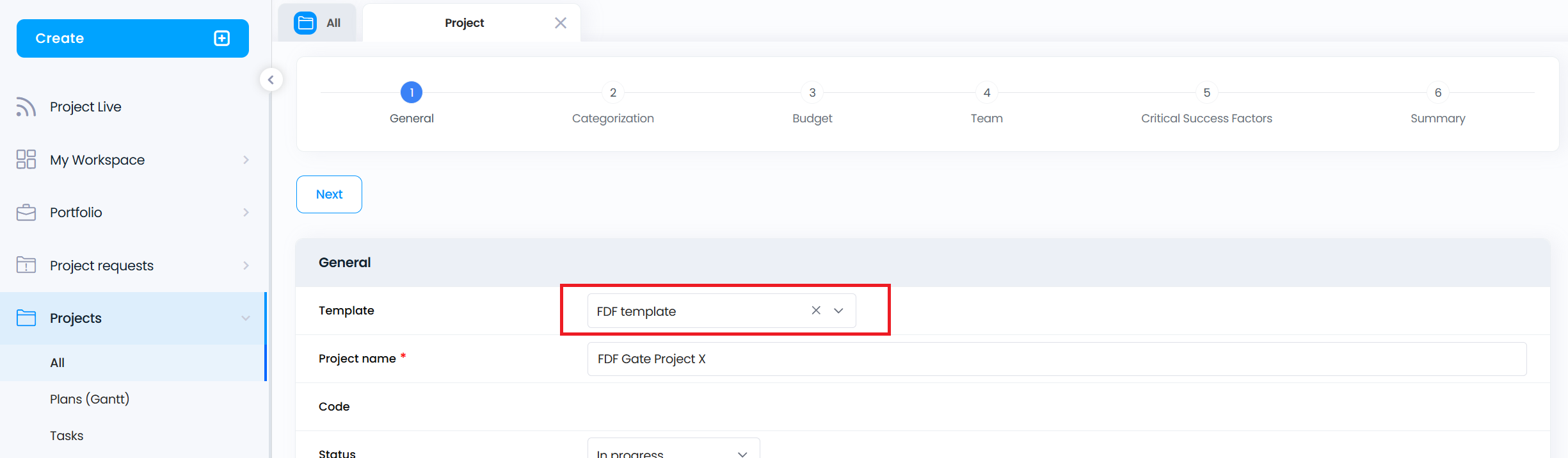

It is important that, during project creation, you select the correct project template and choose the corresponding project type in the categorization settings.





Then complete the remaining project details and save the project.

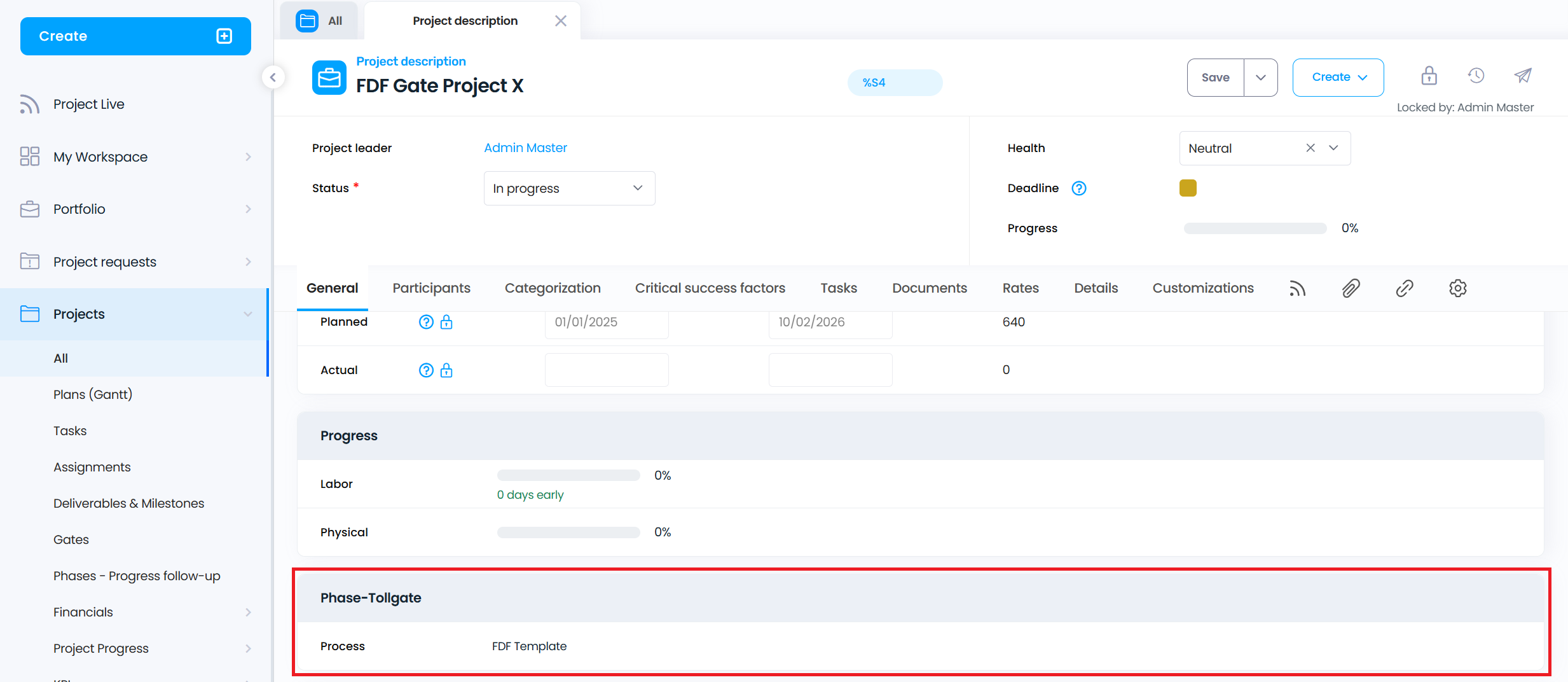

When you reopen the project, the section "Phase-Tollgate" should appear below the "Progress" section (see screenshot) and reference the assigned project template.

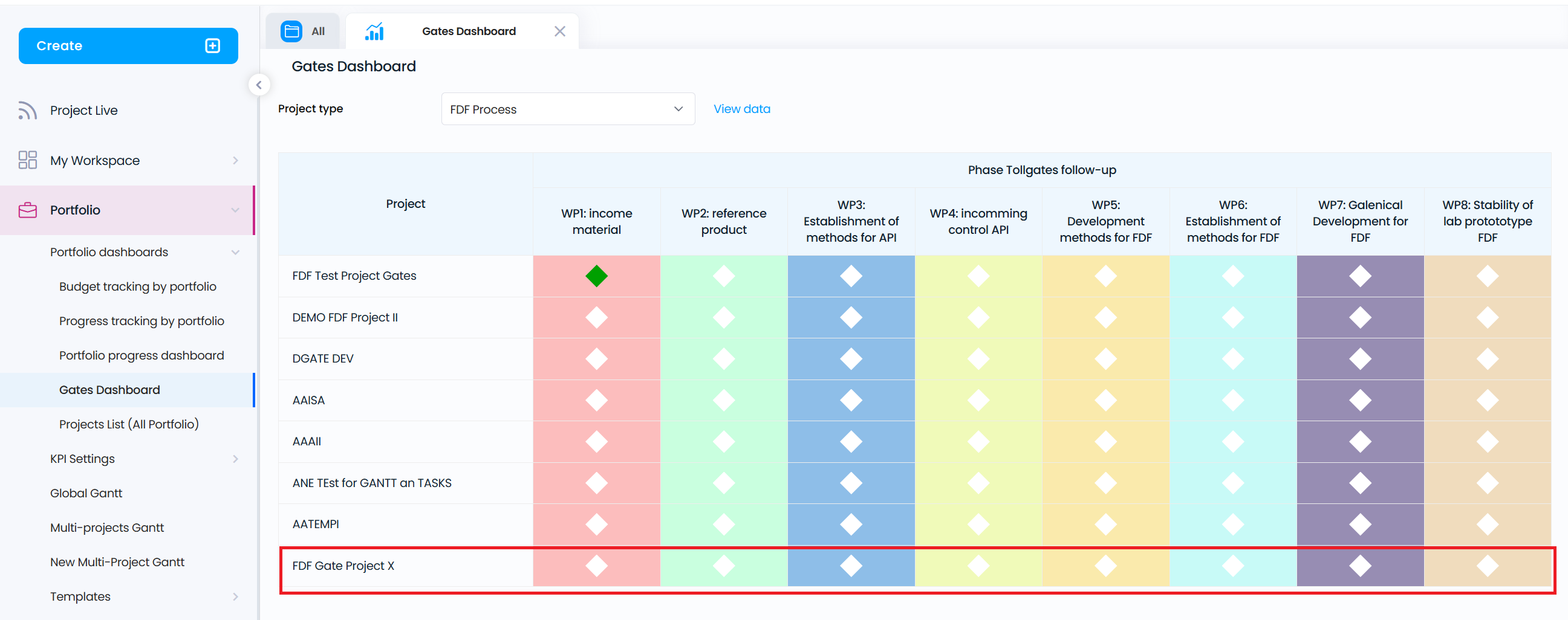

After the assignment has been completed, the project will also appear in the Gates Dashboard. Make sure that you select the correct project type.

The dashboard displays the different gates and their current status. By clicking on the icon, you can open the gate documents directly.

Please note that an agent in the portfolio database must run before the dashboard is updated. This agent typically runs once per hour.



    • Related Articles

    • Phase Review Template (v10.xx)

      Cerri Project can map to a wide variety of phase review processes. There can be as many phase review templates as needed. The setup described below should be used as a guideline and is not carved in stone. Alternate configurations are possible. Any ...
    • Phase Review Template (v8.xx)

      Geniusproject can map to a wide variety phase review processes. There can be as many phase review templates as needed. The setup below described should be used as guidelines and is not carved in stone. Alternate configuration is possible. Any phase ...
    • Cerri Phase Gate Review Cheat Sheet (v10.xx)

      Phase gate review, or Stage-Gate®, is a standardized process divided into phases. Each phase includes a Go/No-Go decision point, referred to as a tollgate. Tollgates can server as either entry points for the current phase or exit points for the next ...
    • Genius Phase Review Cheat Sheet (v8.xx)

      Phase review, or Stage-Gate®, is a process with standardized phases. Each phase has a Go/No-Go decision point called tollgate. The tollgate can be an entry point to start the current phase or an exit point to start the next phase (by default in ...
    • What is a Phase Review Process (v10.xx)

      Thanks to its extreme flexibility, Cerri Project can adapt to any process or methodology. One of the more popular industry methodologies is phase-gate review, also known to as a Tollgate or Stage-Gate® process. This document explains how to leverage ...
