The Budget (v8.xx)

The Budget (v8.xx)

A project budget is always created with the creation of a new project using the wizard. Depending on the setup there can be one or several budgets for a project. Projects with multiple budgets have been broken out into periods. To find out more about budgets by period, see the chapter on advanced budget management. The chapter deals solely with the default configuration, one budget per project.


There are two ways to access a project’s budget:


Click on the "Budget" link in the "Cost & Budget" of the Project Description document.



  • Or, navigate to the [Projects] tab.

  • Select "Costs & Budget" from the contextual navigation menu.

  • Select "Budget" and then the budget you would like to open from the choices in the content window.



The budget form allows you to define all aspects of the project’s budget. Geniusproject defines the


budget using the following axes (categories):


  • Internal work (labor): All of the hours worked by "internal" resources.

  • External work (labor): All of the hours worked by "external" resources (subcontractors, partners, etc.).

  • Investment & Expenses (non-labor): All non-labor related costs (purchases, travel costs, rentals, etc.).

There are two types of budget formats, a detailed budget and a flat non-detailed one. They both originate from the same form but depending on the selected format, the available options will be different.


  1. Create Budget document

Since Version 8.00 it is possible to create a project without a Budget document. To create a Budget document there are several possibilities:


Create a Budget document by clicking on "Budget" inside the Project Description.


From the content window click on the [Create] menu and select "Budget".


From the Menu Tab "New budget".



  1. The budget header




Project

The project that the budget belongs to.




This is the main identifier of the project. It can be the project name or name and code, depending on what has been defined in the General setup document of the [Projects] module. The project name and code are entered in the Project description document and are included in all of the project documents.

The label is a link to open the corresponding "Project description" document directly.

Project leader

The project’s main project leader (as opposed to the project leader substitute)

Deadline

Version number

Version

Document version number

Last modification

Date and time of the last modifications. By clicking on the date you can access the history of the modifications


Last Comment

Displays the last comments made on the budget. You can reply directly to the comments by clicking on "Reply" and you can create a new discussion by clicking on "New discussion". See "Collaborate with Genius Live!" for more information.


  1. Non-detailed budget definition


For a non-detailed budget, a pool of days for labor will be defined, split across internal and external resources. There will be a defined total for internal cost as well as external cost if the project billable.


A global amount will also be defined for investments and expenses, all non-labor costs.







Billing mode

Possible billing mode options are: Fixed price

Not billable

Time and material

Not editable, the value is inherited from the project description.

Detailed budget

Select "No" for not detailed budget.

Internal labor

Days

Amount of labor budgeted for internal resources.





Budget

Budgeted cost for labor by internal resources.

Billing

Amount of billable labor budgeted for internal resources.

Not displayed if project is not billable.


Margin

Budgeted margin on internal labor cost. Computed = Budgeted – billing.

Not displayed if project is not billable.





External labor

Days

Amount of labor budgeted for external resources.

Budget

Budgeted cost for labor by external resources.

Billing

Budgeted billing amount for labor by external resources.

Not displayed if project is not billable.


Margin

Budgeted margin on external labor cost. Computed = Budgeted – billing.

Not displayed if project is not billable.




Investments & Expenses

Budget

Budgeted amount for non-labor costs

Billing

Budgeted billing amount for non-labor costs.

Not displayed if project is not billable.


Margin

Budgeted margin on non-labor cost. Computed = Budgeted – billing.

Not displayed if project is not billable.





Total

Days

Total budgeted labor days (workload)

Budget

Total budgeted cost for the project

Billing

Total budgeted billable amount. Not displayed if project is not billable.


Margin

Budgeted total margin on internal labor cost. Computed = Budgeted – billing.

Not displayed if project is not billable.


  1. Detailed budget


As its name suggests, this budget format allows you to include more layers of detail in your budget. Instead of just defining high level of labor and non-labor related costs, the detailed budget allows costs to be defined at a more granular level; by activity type.


The axis or axes used to make up the budget are defined in the General setting of the [Portfolio] module. For the purposes of this chapter we will be focusing on the default single axes selection, which can be defined as activity and cost types. For more information see the chapter on advanced budget management.


The first is somewhat the same as that of the non-detailed budget, however now it displays consolidated totals of the information detailed out on the [Internal Labor], [External Labor] and [Inv. & Exp] tabs.



  1. [Description] tab




Billing mode

Possible billing mode options are: Fix price

Not billable

Time and material

Not editable. Inherited from the project description document.

Detailed budget

Select "Yes" for detailed budget.







Internal labor

Days

Amount of labor budgeted for internal resources.

Computed. Total number days defined on the [Internal labor] tab.

Budget

Budgeted cost for labor by internal resources.

Computed. Total of cost defined in [Internal labor] tab.


Billing

Budgeted billable amount for labor by internal resources.

Computed. Total amount defined on the [Internal labor] tab. Not displayed if project is not billable.


Margin

Budgeted margin on internal labor cost. Computed = Budgeted – billing.

Not displayed if project is not billable.







External labor


Days



Budget

Amount of labor days budgeted for external resources.

Computed. Total number of days defined on the [External labor] tab.

Budgeted cost for labor by external resources.

Computed. Total cost defined in [External labor] tab.


Billing

Billable amount budgeted for labor by external resources. Computed. Total amount defined in [External labor] tab.

Not displayed if project is not billable.


Margin

Budgeted margin on external labor cost. Computed = Budgeted – billing.

Not displayed if project is not billable.





Investments & Expenses

Budget

Budgeted amount for non-labor costs.

Computed. Total of costs defined in [Inv & Exp] tab.


Billing

Budgeted billable amount for non-labor costs.

Computed. Total amount defined in [Inv & Exp] tab Not displayed if project is not billable.


Margin

Budgeted margin on non-labor cost. Computed = Budgeted – billing.

Not displayed if project is not billable.








Total

Days

Total amount of days budgeted for labor (workload).

Budget

Total cost budgeted for the project.

Billing

Total budgeted billing amount.

Not displayed if project is not billable.


Margin

Budgeted total margin on internal labor cost. Computed = Budgeted – billing.

Not displayed if project is not billable.

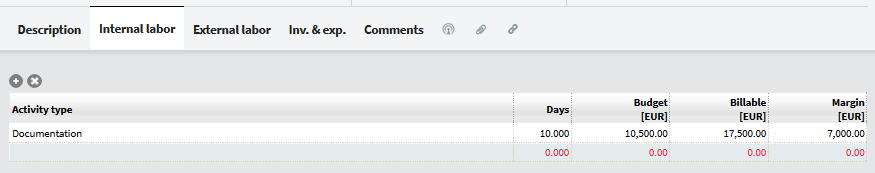

  1. The [Internal labor] tab

This tab is used to define the detailed breakdown of workload and costs for internal labor. The user can add as many lines as necessary to the grid; one activity type per line. The list of available activity types is created as part of the keyword configuration in the setup of the module.



Grid buttons


To add a new line to the budget.

To remove a selected line from the budget.





Grid

Activity type

The activity type the budget line is being defined for.

Days

Amount of days budgeted for labor by internal resources.

Budget

Budgeted cost of labor by internal resources.

Billable

Budgeted billable amount for labor by internal resources.

Not displayed if project is not billable.

Margin

Budgeted margin on internal labor cost.

Not displayed if project is not billable.


  1. The [External labor] tab

Same as the [Internal labor] tab however values are defined for external labor.



  1. The [Inv & Exp] tab

This tab is used to define the details non-labor related costs, referred to in Geniusproject as "Investments and expenses". The user will be able to create as many entries as necessary in the data entry form. Normally input by cost type. The cost types of are defined in the configuration of keywords.



Grid buttons


To add a new line to the budget.

To remove a selected line from the budget.




Grid

Cost type

The type of cost the budget line is being defined for.

Budget

Budgeted cost.

Billable

Budgeted billable amount.

Not displayed if project is not billable.

Margin

Budgeted margin.

Not displayed if project is not billable.
